Implementation Guide

8D Reports.

An 8D report is a team-based, evidence-bound problem-solving standard used when a defect reaches a customer: nine disciplines from emergency response (D0) through containment, verified root cause and validated correction to prevention and team recognition (D8). Its quality is decided in D2, the problem description. A problem you cannot describe precisely, what, where, when, how many, is and is not, you cannot solve. The customer reads your 8D as a sample of how your whole plant thinks.

What an 8D is

8D, eight disciplines, is a structured problem-solving method built for the situation where a defect has reached a customer. It is team-based: a named cross-functional team, not one engineer with a template. It is customer-facing: the output is a report the customer will read, judge and often audit. And it is evidence-bound: every claim in it, from the containment quantities to the root cause to the validation, must be backed by something that was counted, tested or reproduced.

The format was standardized at Ford in the 1980s and spread through the automotive supply chain, where customer quality manuals still mandate it for complaints. It has long since crossed industries: electronics, medical devices, aerospace and general manufacturing all use 8D or a close relative, because the underlying logic, contain fast, describe precisely, prove the cause, prove the fix, prevent recurrence, is not specific to cars.

One thing before the mechanics: the customer reads your 8D as a sample of how your whole plant thinks. A vague D2, an unverified D4 and an empty D7 tell them more about your operation than any audit, because this is your problem solving with the pressure on. That is worth engineering hours. It is also why the worst thing you can do with 8D is treat it as a form to fill.

Where 8D sits in the problem-solving ladder

On the TeamGuru deployment roadmap, 8D belongs to the structured problem solving practice in the Run stage, and it is the formal end of the ladder. The ladder runs from a 5 whys huddle for same-day deviations, through an A3 for chronic internal problems worth weeks of study, to 8D when a customer is involved and the analysis must survive external scrutiny. The underlying discipline of all three is the same root cause and corrective action logic; 8D adds the team mandate, the containment clock and the escape point.

When 8D is required, and when it is chosen

For customer complaints and escapes, the question usually answers itself: the customer's supplier quality manual mandates an 8D, sets the deadlines, and often provides the portal the report must be submitted through. Treat those timing rules as contractual, because functionally they are.

Internally, 8D is a choice, and it should be made sparingly: reserve the full format for major problems, safety-relevant escapes caught at final test, or repeat failures that crossed departments. Do not 8D every scratch. Format fatigue is real, and it kills quality: a plant that writes forty routine 8Ds a month writes forty shallow ones. Signs the full 8D is the wrong tool:

  • A one-off internal deviation with a known cause and a trivial fix. Fix it, record it, move on. An 8D here is paperwork cosplay.
  • A chronic internal problem that needs weeks of study but has no customer attached. That is A3 territory: same rigor, lighter format, built for coaching.
  • A problem where the solution is already known and only execution remains. That is a project with actions and dates, not an investigation.
  • Every scratch and cosmetic blemish by default. If everything is an 8D, your engineers will learn to write them fast instead of well, and the reports your customers actually read will be written in that same tired style.

The nine disciplines, D0 to D8

The timing column reflects common customer expectations, especially in automotive: containment inside 24 hours, root cause through validation inside 30 days. They are typical, not universal, so check each customer's manual. What is universal is the order: containment before analysis, verified cause before actions, validation before closure.

Discipline What good looks like Typical timing
D0 Emergency response The symptom is acknowledged, anyone at immediate risk is protected, and a deliberate decision is made whether the problem warrants a full 8D. D0 is triage, not analysis: stop the bleeding, then decide the tool. Same day
D1 Team Four to six people who together know the process, the product and the data: someone who runs the process daily, quality, engineering, and a champion senior enough to remove obstacles. One named contact for the customer. Within 1 to 2 days
D2 Problem description The problem in numbers: what exactly, where exactly, when first and how often since, how many out of how many, and an is/is-not analysis that fences the problem in. No causes, no opinions, no blame. A stranger could pick up D2 and know precisely what happened. Within 2 to 3 days
D3 Interim containment The customer is protected at every point in the pipeline: their line, goods in transit, your finished goods, your WIP. Sort results are counted and dated, suspect stock is fenced, and containment effectiveness is verified with data, not assumed. Within 24 hours
D4 Root cause and escape point Two verified cause chains, not one: why the defect occurred, and why it escaped every control between the process and the customer. Each root cause is proven by evidence or reproduction, and the escape point names the specific control that should have caught it. Within 2 weeks
D5 Chosen corrective actions Actions selected against the verified causes, occurrence and escape both, with evidence they will work: a trial, a test, a demonstration. Retraining alone is not a corrective action; it treats the person, not the process. With D4 to D6 inside 30 days
D6 Implementation and validation Actions implemented with owners and dates, then validated with production data showing the defect is gone under normal conditions. Containment is removed only after validation, never before, and the removal date is recorded. Within 30 days
D7 Prevention The system is changed so the problem class cannot return: FMEA and control plan updated with revision references, standards revised, and a lookacross completed on similar parts, processes and lines with findings documented. 30 to 60 days
D8 Team recognition A closure review that captures what the case taught the system, and honest recognition of the team. Skipping D8 teaches people that problem solving is punishment, and the next 8D team will be harder to staff. At closure

How to run an 8D that survives scrutiny

Most of the disciplines are self-explanatory once the table above is taken seriously. Four of them decide whether the report holds up, and they deserve the detail below.

D2 decides the whole report

8D quality is decided in D2. Every weak problem description produces a D4 written by guesswork, because a cause chain can only be as sharp as the effect it explains. Spend the time here: what exactly is wrong, in measurable terms; where exactly, down to the position and feature; when it started and how the occurrence trends; how many out of how many, with part numbers and lot or serial ranges.

Then fence it with is/is-not. An illustrative case from the 456 units per day components plant used across these guides: a customer reports leaking hydraulic fittings. The weak D2 says "fittings leak at customer, investigating." The strong D2 says: seepage at the left port fitting only, 7 confirmed units out of 3,400 delivered since June 10, all from lots machined on line 2 after the tooling change, none from line 1, none on the right port machined at the same station with the older tool. That one paragraph has already done half of D4's work: the is/is-not points straight at the line 2 tooling change, and the team can go verify instead of brainstorm. Keep causes out of D2 itself; the moment a suspected cause appears in the description, the team stops describing and starts defending.

D4 needs two chains, not one

Every customer complaint is two failures. The defect occurred, and then it escaped every control between your process and the customer's dock. D4 therefore runs two cause chains. The occurrence chain asks why the defect was made, and a disciplined 5 whys with each answer verified at the process is usually the right tool. The escape chain asks why it was not caught, and it ends at the escape point: the specific control, an inspection, a test, a poka-yoke, that should have detected the defect and did not, or the honest admission that no such control existed.

Both chains end in verification, not consensus. The standard of proof worth holding: you can make the defect appear and disappear by switching the cause on and off, or you have physical evidence that survives a skeptical reading. A root cause agreed by vote in a meeting room is a hypothesis wearing a suit.

D5 and D6: prove it before you claim it

Choose corrective actions against both verified causes: one set that stops occurrence, one that closes the escape. Verify the choice before full implementation, with a trial run, a test rig, or a deliberate attempt to defeat the new control. Then validate in D6 with production data: defect-free output under normal conditions, in quantities large enough to be meaningful, after which containment is removed and production stays clean. Closing an 8D on "actions implemented" without validation data is the single most common shortcut, and it is exactly the point a good customer SQE will attack.

D7 is prevention, and prevention means lookacross

D7 asks what in the system allowed this problem, and fixes it there: the FMEA gets the new failure mode or corrected ratings, the control plan gets the new check, the affected standards get revised, all with revision references the customer can audit. Then the lookacross: every similar part, process and line checks itself against the same failure mode within days, not quarters, and the findings are documented even when they are clean. A D7 that says "FMEA updated" with no revision number and no lookacross list is a promise, not a discipline.

The approver's checklist

Someone signs the report before it goes to the customer, and that signature should mean something. These are the questions to ask, discipline by discipline, before releasing. If an answer is missing, the report is not late because of the approver. It is early.

Discipline Ask before releasing
D1: Team Does the team include someone who runs the process every day? Is the champion senior enough to free people and money? Is one person named as the customer's single contact?
D2: Description Are what, where, when and how many stated in numbers, with part numbers and serial or lot ranges? Is there an is/is-not analysis? Does the description avoid naming any cause? Could someone outside the plant reproduce your understanding from this page alone?
D3: Containment Is every location covered: customer line, transit, finished goods, WIP? Are sort quantities and results counted and dated? Would the customer agree they are protected today, not next week?
D4: Root cause Are there two chains, occurrence and escape? Was each root cause verified by switching it on and off, reproducing the defect, or hard evidence, rather than by vote in a meeting room? Does the escape point name the specific control that failed?
D5: Chosen actions Does every action attack a verified cause? Is any action just retraining or reminding people standing on its own? Is there evidence, a trial or test, that the chosen actions will actually work?
D6: Validation Is there before and after production data, not just a statement that actions are done? Has containment been removed, and did the defect stay gone after removal? How many parts or days of clean production back the claim?
D7: Prevention Are the FMEA and control plan updates referenced by revision? Is the lookacross to similar parts and lines documented with owners and dates, not promised? Did any sister process check itself and find something?
D8: Closure Did the team review what this case revealed about the system, not just the part? Has anyone actually thanked the team, in a way the team noticed?

Working with the customer

An interim answer on time beats a perfect answer late, every time. The customer's quality team is holding your parts and someone else's schedule; what they need on day one is not your root cause, it is proof that they are protected and a date for the next update. Send D1 to D3 when they are due even though D4 is a hypothesis, label the hypothesis as one, and keep every promised date. A supplier who communicates on schedule with partial answers builds trust; a supplier who goes quiet for three weeks and returns with a polished report does not.

Name the containment honestly. If the interim action is a 100 percent visual sort, write "100 percent visual sort" and its measured effectiveness, not "enhanced inspection." If certified stock will take four days to reach the customer, say four days. Customers forgive defects far more readily than they forgive discovering that a containment claim was optimistic, because the first is a process failure and the second is a character one. Keep one voice: the D1 customer contact handles all communication, so the customer never hears two versions of the same status.

Common failure modes

Four patterns account for most bad 8Ds, and all four are visible to the customer.

D4 written to sound good

The root cause is drafted for customer acceptance instead of truth: plausible, generic, and unverified. The test is simple: can you turn the cause on and off and make the defect appear and disappear? If not, the chain is a story. Customers who read many 8Ds recognize the genre immediately, and it costs you more credibility than a late report would.

Containment becomes the fix

The 100 percent sort quietly turns permanent, the case closes, and six months later the plant is paying two inspectors per shift to not solve a problem. Containment is a tourniquet. If D3 is still running when D6 should be validated, the 8D has stalled and the clock, not the report, should say so.

D7 skipped or faked

The report says FMEA updated with no revision number, and the lookacross is a sentence, not a list. Then the same failure mode appears on a sister part eight months later, and the second 8D is much harder to write, because the customer's first question is why your own prevention discipline did not catch it.

8D as punishment

The report is assigned to whoever is blamed, written alone at night, and reviewed like homework. Quality collapses, because the whole method assumes a team and evidence. If your engineers groan at the word 8D, the format has been abused, and the fix is management behavior, not another template.

What happens next

A closed 8D is data, not just relief. Track recurrence across cases: the repeat-problem rate is the honest KPI of the whole problem-solving system, and clusters of related cases point the improvement pipeline at the process families that need FMEA reviews, error-proofing or redesign through the kaizen practice. For the internal chronic problems the cases keep exposing, the lighter A3 format carries the same discipline without the customer overhead, and the RCCA guide covers the effectiveness checks that keep any closure honest.

The practical bottleneck in most plants is not the method, it is the assembly of the report: evidence in email threads, sort counts in spreadsheets, photos on phones, and an engineer rebuilding it all into a document at 9 pm before the customer deadline. This is where TeamGuru earns its place in the chain: the 8D problem solving workflow runs the disciplines as steps with evidence, owners and dates attached to each, and quality alerts connect the original escape to the containment actions on the floor. The report the customer receives becomes a by-product of work that was tracked while it happened, which is also the version of the story an auditor believes.

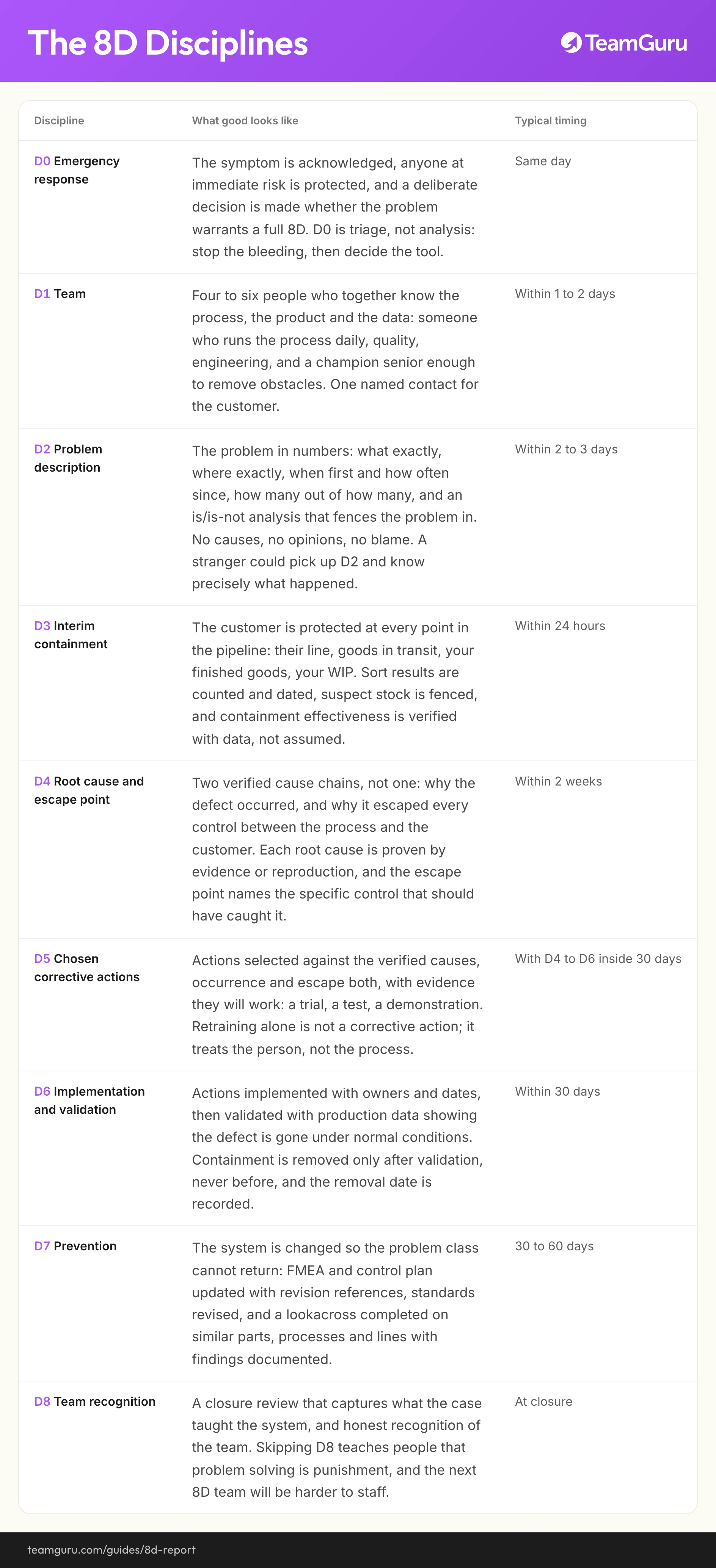

8D Reports implementation diagram (TeamGuru guide)
Take this with you: free to reuse in internal training and workshops. Download PNG

Frequently asked questions

What are the 8 disciplines of the 8D process?
D1 team, D2 problem description, D3 interim containment, D4 root cause and escape point, D5 chosen corrective actions, D6 implementation and validation, D7 prevention, D8 team recognition. Most modern versions add D0, emergency response, at the front, which is why the process now has nine steps but kept its name.
When is D0 used?
D0 covers the first hours after a problem surfaces: protect anyone at risk, take emergency action such as stopping shipments, and decide whether the problem warrants a full 8D at all. It exists so that triage and analysis do not get mixed, and so trivial issues can be handled without launching the full process.
How fast does an 8D have to be?
Common customer expectations are containment confirmed within 24 hours, D1 to D3 submitted within 2 to 3 days, and D4 to D6 within 30 days, with D7 and D8 closing in 60. These are typical, not universal: check each customer's supplier quality manual. The deadline that matters most is the first one, because a late containment answer tells the customer they are not protected.
What is the difference between 8D, A3 and RCCA?
RCCA is the underlying discipline: find the verified root cause, correct it, prove the correction worked. A3 and 8D are formats that package that discipline. A3 is a one-page, coaching-oriented format for internal chronic problems. 8D is a team-based, customer-facing format with mandated containment, escape point analysis and prevention steps, used when a defect has reached or endangered a customer.
Who should be on an 8D team?
Four to six people who together know the process, the product and the data: an operator or team leader from the process, a quality engineer, a process or design engineer, and a champion with the authority to free time and money. Add the customer contact role explicitly. A one-person 8D is a report, not an investigation, and customers can tell.
What is an escape point in an 8D?
The escape point is the earliest control in your process that should have detected the defect and did not: an inspection, a test, a poka-yoke, a control plan check. D4 requires finding it because every customer complaint is two failures, one of occurrence and one of detection, and fixing only the first leaves you exposed to the next occurrence.
